About Strategy Plan :
The strategy plan incorporates where maintenance activity based on each other or supersede each other.The ability to vary the intervals as well as the task list operation application based on intervals.
Process Flow (Time Based Strategy Plan)
Step 1 : Create Strategy - IP11
Call Horizon :
Call horizon is used to propose a pre call date for the maintenance plan. for example if the maintenance plan is for every 1 month and you need to release the call say 3 days before , then you specify the call horizon as 90 % and hence it will release the call on 27th day. For releasing the call you have either run IP10 manually or IP30 regularly.
Tolerance and Shift Factor :
When the preventive maintenance order is completed outside of the shift tolerance limits, the shift factor determines the adjustment to be made on calculating the next planned date. Example, an order was completed 15 days late outside of 10% tolerance with shift factor 50% the next plan date is delayed 7.5 days.
Step 2 : Create General Maintenance Task List - IA05
Step 3 : Create Strategy Plan - IP42

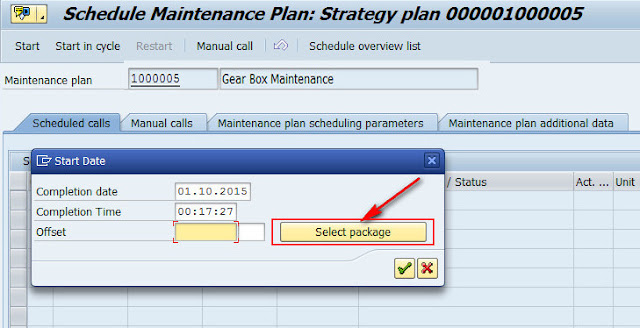

Step 4 : Schedule Maintenance Plan : IP10
Deadline Monitoring : IP30
Maintenance Order will generate automatically.
Now Check by IW38
Its showing two Maintenance Order has been generated through maintenance plan.
Also Can check by IP10
Its showing two schedule has been called and created preventive maintenance order and next maintenance plan date is 30.12.2015
The strategy plan incorporates where maintenance activity based on each other or supersede each other.The ability to vary the intervals as well as the task list operation application based on intervals.
Process Flow (Time Based Strategy Plan)
Step 1 : Create Strategy - IP11
Call Horizon :
Call horizon is used to propose a pre call date for the maintenance plan. for example if the maintenance plan is for every 1 month and you need to release the call say 3 days before , then you specify the call horizon as 90 % and hence it will release the call on 27th day. For releasing the call you have either run IP10 manually or IP30 regularly.
Tolerance and Shift Factor :
When the preventive maintenance order is completed outside of the shift tolerance limits, the shift factor determines the adjustment to be made on calculating the next planned date. Example, an order was completed 15 days late outside of 10% tolerance with shift factor 50% the next plan date is delayed 7.5 days.
Step 2 : Create General Maintenance Task List - IA05
Step 3 : Create Strategy Plan - IP42
Step 4 : Schedule Maintenance Plan : IP10
Save :
Deadline Monitoring : IP30
Maintenance Order will generate automatically.
Now Check by IW38
Its showing two Maintenance Order has been generated through maintenance plan.
Also Can check by IP10
Its showing two schedule has been called and created preventive maintenance order and next maintenance plan date is 30.12.2015
